AAC thin-bed mortar method statement: 1.5 mm joint, notched trowel, rubber mallet

Table of Contents
  1. Substrate and first-course tolerance
  2. Materials: notched trowel, rubber mallet, plastic-stage correction
  3. Bond performance, shear, and code requirements
  4. Thin-bed versus thick-bed: when thin-bed fails
  5. Quality control on site: moisture, sanding, joint fill
AAC thin-bed mortar method statement: 1.5 mm joint, notched trowel, rubber mallet

AAC blockwork laid in thin-bed mortar uses joints of approximately 1/16 inch (1.5 mm) spread with a notched trowel that fully fills the bed and head joints, struck on the ends and tops of each unit with a rubber mallet, with corrections made only while the mortar is still plastic, as set out in the New York State Building Code 2010 section 2104.1.2.6 [S2].

Autoclaved aerated concrete (AAC) is a closed-void, steam-cured, cementitious unit that typically weighs one-sixth to one-third as much as conventional concrete and is roughly one-sixth to one-third as strong, suitable for bearing walls and shear walls in low- to medium-rise structures, with thermal conductivity of about one-sixth that of normal-weight concrete [S3]. Material properties for AAC units are prescribed in ASTM C1386 [S3], and Australian design sits under AS 3700-2011 Masonry structures with footings designed to AS 2870-2011 [S1].

Substrate and first-course tolerance

AAC masonry construction shall begin with a leveling course of masonry meeting the requirements of the controlling code section, and subsequent courses of AAC units shall be laid with thin-bed mortar using a notched trowel that completely fills the bed joints, with head joints filled similarly unless otherwise specified, per NYS 2104.1.2.6 [S2].

The 1.5 mm joint tolerance is the practical limit set by the factory-cut accuracy of the units and by the notched-trowel geometry; tolerances wider than this defeat the thin-bed advantage and start behaving like thick-bed work. A first-course survey of the foundation or slab is non-negotiable: any deviation is multiplied through every subsequent course, and AAC's tight joints leave no room to absorb out-of-level basework. The Australian guidance treats the leveling course as a full or articulated masonry footing designed under AS 2870-2011 for residential slabs and footings [S1], which in practice means using a compatible thick-bed mortar bed (typically M4 / Type S) at the base, not a thin-bed layer on a wavy slab. The Magicrete AAC user manual specifies a 3 mm notched-trowel application for the block-jointing mortar after the leveling course is set, indicating that the 1.5 mm nominal figure in NYS 2104.1.2.6 is a compressed finished joint, not the wet-applied bed [S4].

Materials: notched trowel, rubber mallet, plastic-stage correction

Joints in AAC masonry shall be approximately 1/16 inch (1.5 mm) and shall be formed by striking on the ends and tops of AAC masonry units with a rubber mallet, with minor adjustments in unit position made while the mortar is still soft and plastic by tapping it into proper position; minor sanding of the exposed faces is permitted to provide a smooth and plumb surface, per NYS 2104.1.2.6 [S2].

Three tools drive the quality of a thin-bed AAC wall: a toothed/notched trowel sized to the joint, a rubber mallet, and a rasp or sanding block for face correction. The notched trowel must be the "special notched trowel manufactured for use with thin-bed mortar" called out in code, and its teeth must be kept clean; AAC fines and dried mortar quickly build up on the notches and turn a 3 mm wet bed into an inconsistent 1 to 2 mm film. The rubber mallet, not a steel hammer, is required because steel spalls the AAC skin. Plastic-stage correction is a time-limited operation: once the thin-bed mortar skins over, attempts to re-tap the unit crack the bond line rather than adjust it, and the joint has to be cut out and re-laid. The Magicrete manual reinforces this sequence: a 3 mm notched-trowel application, then unit placement, then rubber-mallet compaction before the bed sets [S4].

Bond performance, shear, and code requirements

AAC block method statement for thin-bed mortar laying - Bond performance, shear, and code requirements
AAC block method statement for thin-bed mortar laying - Bond performance, shear, and code requirements

The shear strength of thin-bed mortar shall meet or exceed the shear strength of the AAC masonry units for wall actions addressed in NYS 2103.11 Mortar for AAC Masonry [S2], so the mortar is a strength-matched partner to the unit, not a generic gap-filler.

Choosing the wrong polymer-modified thin-bed mortar is the single most common cause of low bond pull-off values on AAC jobs. The shear-match requirement in 2103.11 effectively rules out unmodified Portland-cement sand mortar for thin-bed work, because the 1.5 mm joint has no aggregate bridge to develop mechanical interlock and the unit's closed-void surface does not absorb water the way a clay brick does; unmodified mortar dries out at the interface and never hydrates. Factory-premixed AAC jointing mortars such as Magicrete Block Jointing Mortar are formulated for plastic-stage open time and water retention on a non-absorbent substrate, and the user manual calls for a 3 mm troweled bed with full coverage of the unit face [S4]. The block density grade also has a direct effect on the achievable bond: a denser AAC block at Grade 2 has a different surface hardness and suction than a Grade 1 AAC block, and the mortar's grab and open time must be selected against the actual density delivered to site, not the nominal catalog value. Comparing the two density classes on three decision criteria makes the trade visible:

Comparison of AAC block grades on three practical criteria for thin-bed work:

- Shear bond: Grade 1 (lower density) typically gives a higher pull-off on the same mortar because of better suction at the interface; Grade 2 needs a mortar with stronger polymer content to match the unit shear per 2103.11 [S2].

- Dead load per square metre: Grade 2 blocks lift the wall mass noticeably, which matters on floor systems and multi-storey stacks; Grade 1 is the lighter option and reduces handling fatigue on site.

- Mortar coverage: a rougher Grade 1 surface keys the notched-trowel ridges better; a denser Grade 2 surface can leave voids under the ridges if the trowel is not held at the correct angle, and those voids become crack initiators at the head joint.

For the wider masonry context, a dry-mortar reference page covers the family of pre-bagged bedding mortars, including AAC jointing mortars and traditional M4 / Type S thick-bed site mixes, and how they differ in aggregate grading and polymer loading. Designers moving from thin-bed AAC to traditional clay or concrete blockwork should understand the block and brick units that share the same code sections but rely on 10 mm thick-bed mortar rather than a 1.5 mm thin bed.

Thin-bed versus thick-bed: when thin-bed fails

Thin-bed mortar is the most common bedding method for AAC units and is the system to which NYS 2104.1.2.6 and the MSJC Specification are written, but thick-bed mortar is still permitted where dimensional tolerance, base-leveling, or rework scope demands it [S3].

Thin-bed fails on three specific conditions and only those three: a base that is out of level by more than the leveling-course mortar can correct, a wet or frozen unit, and a re-lay where old thin-bed mortar has been ground off and the AAC surface is now too smooth to bond. In each case, the practical recovery is to drop to a 6 to 10 mm thick-bed mortar bed of M4 / Type S on that course, then return to thin-bed once geometry and substrate are restored. The MSJC Specification framing of AAC as "most commonly laid using thin-bed mortar" but not exclusively so [S3] is what allows that hybrid detail without voiding the design. The Magicrete manual similarly treats thin-bed application with a notched trowel at 3 mm as the default thin-bed procedure, while leaving thick-bed repair as a recognised site operation [S4].

Quality control on site: moisture, sanding, joint fill

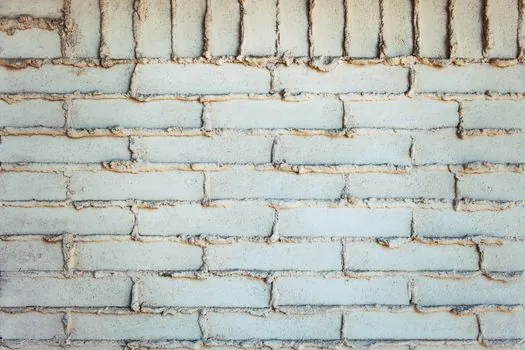

AAC block method statement for thin-bed mortar laying - Quality control on site: moisture, sanding, joint fill
AAC block method statement for thin-bed mortar laying - Quality control on site: moisture, sanding, joint fill

Minor sanding of the exposed faces of AAC masonry is permitted to provide a smooth and plumb surface per NYS 2104.1.2.6, and the thin-bed joint must fully fill the bed and head joints to comply with the same section [S2].

Three site checks catch most thin-bed defects: (1) lift a unit immediately after placement and inspect the underside, a properly notched bed leaves continuous parallel ridges with no bare AAC showing; (2) check head-joint fill by looking down the perpendicular joint before the next unit closes it, hollow head joints are the most common path for a rain penetration claim; (3) check moisture before laying, AAC wicks water from wet conditions and a saturated unit dilutes the polymer-modified mortar at the bond line, the same unit that bonds well at 10 to 20 percent moisture by mass will fail at 40 percent. Density-grade checks are an upstream QC gate: a delivered AAC block outside the density band on the grade certificate is a flag to re-confirm the mortar selection, not a flag to accept the unit. The same moisture and density caveats apply whether the wall is a single-storey residence on a slab designed to AS 2870-2011 [S1] or a medium-rise commercial project, only the consequence of a bad joint changes.

Track the next update against two signals: the AACPA manufacturer group's revision of the MSJC Specification reference cited by Klingner [S3], and the Magicrete Block Jointing Mortar product revision line in the AAC User Manual 2024 PDF [S4]; a third node is any update to ASTM C1386 affecting unit density tolerances and the surface texture the thin-bed mortar is expected to bond to.

See also our earlier report, AGV strengths on fixed-route heavy loads versus AMRs.

Frequently asked questions

What is the specified thin-bed mortar joint thickness for AAC blockwork under NYS Building Code 2104.1.2.6?

Section 2104.1.2.6 of the New York State Building Code prescribes AAC thin-bed mortar joints at approximately 1/16 inch (1.5 mm). The finished compressed joint is 1.5 mm, even when a notched trowel such as the Magicrete 3 mm trowel is used to apply the wet bed before unit placement and rubber-mallet compaction.

Which notched trowel geometry is required for laying AAC blocks in thin-bed mortar?

The code calls for a "special notched trowel manufactured for use with thin-bed mortar," with teeth sized to fully fill bed and head joints. The Magicrete AAC user manual specifies a 3 mm notched-trowel application, which compresses to the 1.5 mm finished joint targeted in NYS 2104.1.2.6, and the teeth must be kept clean of AAC fines to avoid thinning the bed.

Why must a rubber mallet, not a steel hammer, be used to adjust AAC units in the plastic stage?

NYS 2104.1.2.6 requires striking the ends and tops of AAC units with a rubber mallet for plastic-stage correction. Steel hammers spall the AAC skin, while a rubber mallet permits minor repositioning only while the thin-bed mortar is still soft; once it skins over, re-tapping cracks the bond line and the joint must be cut out and re-laid.

Does ASTM C1386 or AS 3700-2011 set the thin-bed mortar joint thickness for AAC masonry?

No. ASTM C1386 prescribes the material properties of the AAC units themselves, and AS 3700-2011 covers Australian masonry design (with footings under AS 2870-2011), but the 1.5 mm thin-bed joint figure is set by NYS Building Code 2104.1.2.6, not by C1386 or AS 3700.
