Shield machine selection for tunneling: 2026 spec and method map

Table of Contents
  1. Main shield types and the geology each one is built for
  2. Selection criteria that actually move the decision
  3. Comparison: EPB shield vs slurry shield vs double-shield TBM
  4. Intelligent control, posture, and the data layer on top
  5. Where the data sources come from and which standards apply
Shield machine selection for tunneling: 2026 spec and method map

A shield machine is selected by matching face-support principle, ground conditioning strategy, and thrust-capacity margin to the actual geology, groundwater head, and alignment geometry, not by diameter alone. EPB and slurry shields together cover most urban metro and undercrossing work, while double-shield TBMs dominate long hydraulic tunnels where high advance rates and simultaneous lining installation are required [S3][S4].

The four decision pillars on a 2026 spec sheet are: grain-size distribution and permeability of the muck, groundwater head and inflow risk, minimum curve radius versus shield length, and segment ring build versus thrust-jack stroke. ITA-AITES Working Group 14 published a dedicated methodology in April 2026 for sizing thrust force of open-mode shielded TBMs in weak rock, recognizing that frictional drag on the shield skin and tail-skin brushes often governs total required thrust, not cutterhead breakout alone [S5].

Main shield types and the geology each one is built for

EPB shields, slurry shields, and open or double-shield hard-rock TBMs form the three-mode menu, with mixshields sitting between EPB and slurry for mixed-face conditions [S4]. Hard-rock machines (gripper TBMs, single-shield, and double-shield) operate dry or near-dry, use disc cutters with high point loads, and grip the wall with gripper pads for reaction; they suit competent rock with low water ingress [S4][S5].

Earth-pressure-balance (EPB) shields stabilize the face with conditioned spoil held under pressure in the excavation chamber, then discharge it through a screw conveyor, making them the default for urban metro in soft, water-bearing soils [S3]. Slurry shields stabilize the face with support fluid and require a separation plant on surface, so they are typically reserved for high-water-head river or undercrossing drives where EPB screw-conveyor gushing cannot be controlled [S3].

For mixed-ground metro work in water-rich sand, the EPB variant is standard, but it must be paired with a soil-conditioning system: foam, bentonite slurry, or polymer is injected at the cutterhead or inside the chamber to bring the muck to a target plasticity and permeability, otherwise screw-conveyor gushing and soil arching block spoil flow and spike cutterhead torque [S3]. Anionic surfactants are the dominant foaming-agent class because their negatively charged hydrophilic head adsorbs onto typically positively charged clay particle surfaces, raising free water and fluidity, and they outperform nonionic and cationic types in foamability across most formations [S3].

Selection criteria that actually move the decision

Permeability and grain size are the first gate: high-permeability coarse sand under high water head pushes the project toward slurry or mixshield, while low-permeability clay and silty clay favor EPB with foam [S3][S4]. Curve radius is the second gate, because a 500 m radius launch has been demonstrated as a workable limit for a roughly 200 m long double-shield TBM only with pre-deflected guide bench, directional reaction frame, short-stroke low-thrust micro-correction, and precise first-ring control [S2].

Thrust capacity must be sized against both boring force and shield skin friction, with the friction term often dominant in weak, squeezing rock where consolidation, creep, and swelling all increase radial loading on the shield [S5]. ITA-AITES Working Group 14 lists three computational routes for squeezing-ground friction: a closed-form analytical approach, the Ramoni and Anagnostou nomograms, and full 3D interaction analysis using FEM, FDM, or DEM coupled to a Convergence-Confinement Method ground reaction curve [S5].

Site assembly footprint is a hard constraint, not a soft preference. A 40 m x 40 m portal cannot accept a 200 m long double-shield TBM in one piece, so the out-of-tunnel integral assembly method must be replaced with split-body stepwise advancement, where the cutterhead shield, main beam, connecting bridge, backup gantries, and belt conveyor are installed in sequence and pushed forward before final integral launch [S2]. The same Meishan Irrigation District case achieved a 444 m monthly advance in March and a 23.39 m maximum daily advance in sandy slate trial excavation, with all parameters below the machine design limits and no shield interference on the 500 m radius curve [S2].

Comparison: EPB shield vs slurry shield vs double-shield TBM

Shield Machine selection for tunneling - Comparison: EPB shield vs slurry shield vs double-shield TBM
Shield Machine selection for tunneling - Comparison: EPB shield vs slurry shield vs double-shield TBM

On the three criteria that drive specification, EPB scores best on urban adaptability and lowest surface-plant footprint, slurry scores best on face stability under high groundwater head, and double-shield TBM scores best on advance rate in long, competent-rock drives with simultaneous segment erection [S2][S3][S4].

For a project with a confined 40 m x 40 m portal and a 500 m curve, the double-shield TBM with split assembly is the demonstrated 2026 solution, as published in the Frontiers in Earth Science case study on 19 August 2026 [S2]. For a metro tunnel in water-rich sand with low surface-plant budget, the EPB with foam (anionic surfactant at project-specific concentration) remains the default, as quantified in the Nature Scientific Reports 2026 conditioning study [S3].

Intelligent control, posture, and the data layer on top

Shield posture control failures (pitching, offset, snaking) propagate directly into segment cracking at the shield tail, ground settlement, and route deviation, so the 2026 control literature treats attitude prediction as a first-class problem rather than an operator-display readout [S1][S6]. Ensemble and gradient-boosting models are the practical baseline: Hu et al. reported a 12% accuracy gain on multistep shield attitude prediction using XGBoost versus random forest, with the trade-off being significantly higher training time on preordered complex features [S1].

LightGBM reaches millisecond-level response in cutterhead torque prediction, which is useful for real-time intervention, but it is sensitive to geological mutations and tends to drift when strata change abruptly across a mixed-face interface [S1]. CatBoost is the 2026 favorite for underground-space datasets because it handles categorical geological descriptors natively without manual one-hot encoding, which reduces overfitting on sparse features common in tunnel boring logs, and it is frequently paired with the crested porcupine optimizer (CPO) for hyperparameter tuning to lift prediction efficiency [S1].

Resilience design in soft-soil metro shields, published in 2026, links shield posture quality directly to segment damage probability and to the redundancy the lining needs to tolerate a single adverse loading event, making posture control a structural-design input, not just an operational KPI [S6].

Where the data sources come from and which standards apply

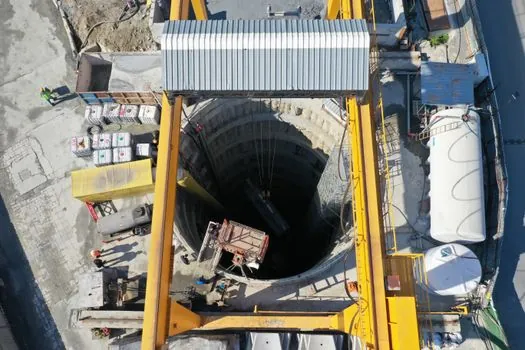

Shield Machine selection for tunneling - Where the data sources come from and which standards apply
Shield Machine selection for tunneling - Where the data sources come from and which standards apply

The geological and conditioning facts above are grounded in two 2026 peer-reviewed papers: the foaming-agent and mechanical-performance study in Nature Scientific Reports (selection criteria for conditioned soil in water-rich sand) and the double-shield TBM split-assembly case in Frontiers in Earth Science, published 19 August 2026 [S2][S3]. The thrust-force methodology for open-mode shielded TBMs in weak rock comes from ITA-AITES Working Group 14 Report N°44, ISBN 978-2-9701807-7-7, April 2026, which references DAUB recommendations, the Ramoni and Anagnostou nomograms, and the Convergence-Confinement Method framework with rock-mass inputs GSI, RMR, and Q [S5].

The intelligent-control and posture-control facts come from the 2026 Advanced Engineering Informatics review on STM attitude prediction and the 2026 Springer rail-engineering paper on resilience-based subway shield design in soft soils [S1][S6]. A practitioner-level typology of gripper, single-shield, double-shield, EPB, mixshield, and slurry machines is given in the Darda knowledge base, which is consistent with the ITA-AITES classification used in the WG14 report [S4][S5].

For specification work, pair the ITA thrust-force framework with the shield-type decision logic above and the conditioning-agent selection matrix from the 2026 foam study; treat the 12% XGBoost accuracy gain over random forest and the 444 m monthly advance on the Meishan drive as anchor numbers when benchmarking vendor claims [S1][S2]. When the alignment throws a 500 m curve at a 200 m long machine, the split-assembly and short-stroke micro-correction procedure in the 2026 Frontiers paper is the closest thing to a published recipe available this quarter [S2].

Track the following 2026 signals before final specification: revision status of ITA Report N°44 errata from Working Group 14, peer-reviewed replication of CatBoost-plus-CPO gains on multi-site shield datasets beyond the 2026 Advanced Engineering Informatics study [S1], and any follow-on Meishan-style cases that extend the 500 m curve-radius limit for double-shield TBMs beyond the current 23.39 m daily advance benchmark [S2]. A side-reading on spec-driven material selection, useful when matching segment ring steel to ground chemistry, is the brick selection map for industrial facilities, which follows the same criteria-led format used here. For adjacent equipment decisions on the same site, the total station spec map for concrete work and the total station map for steel construction cover the survey-control side of the alignment problem.

The underlying component specifications are covered under shield machine, face shield, and coding machine.
